As of February 28, 2023, the sanitary sewer replacement is overall 72% complete. Listed below are highlights of the project along with an attachment of the overall project timeline.
- Wolf Island
- Sanitary sewers have been installed and passed inspection.
- Road reconstruction and restoration is complete.
- Final site restoration continues.

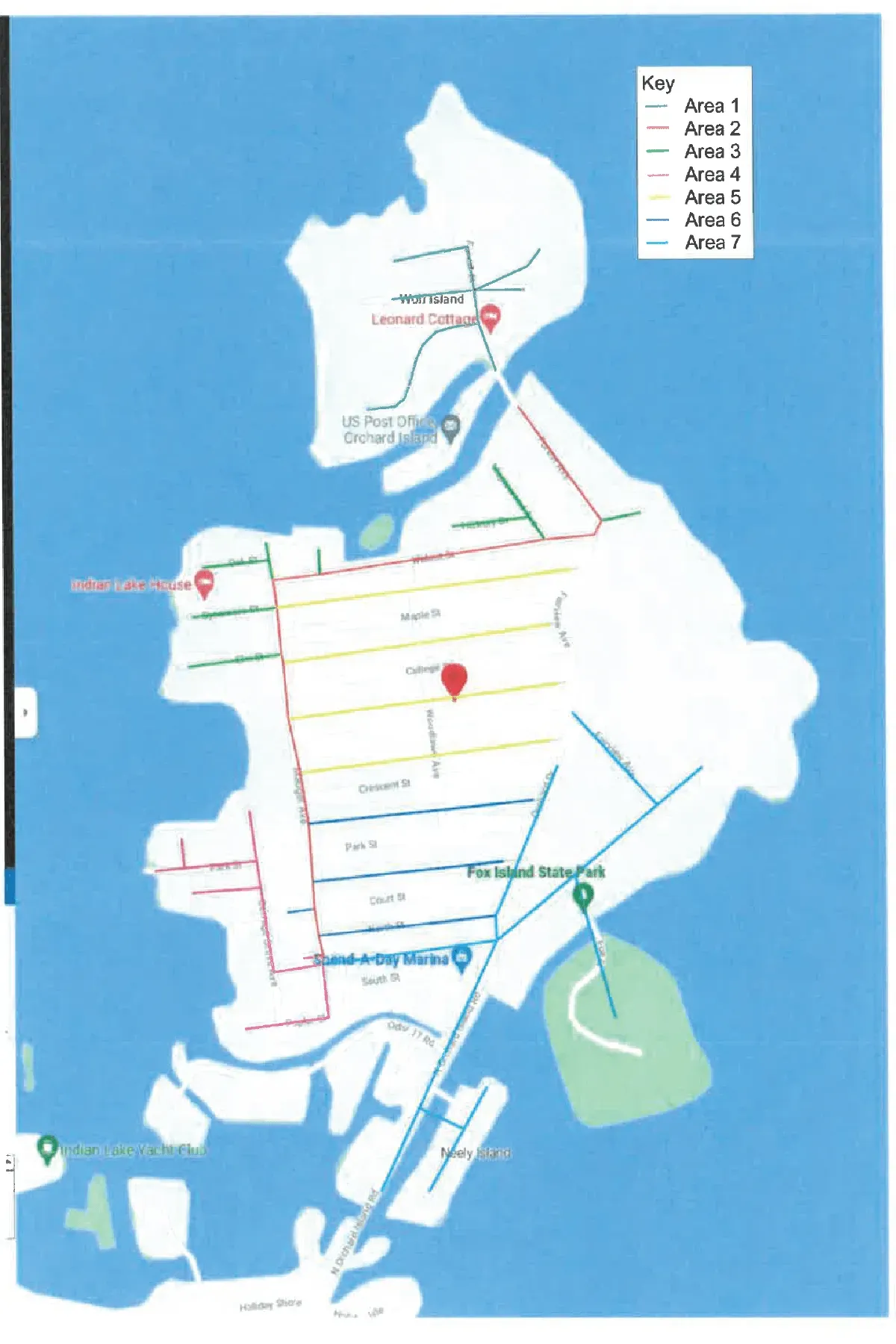

- Orchard Island
- Sanitary sewers have been installed and are waiting for testing and inspection for Mauger Ave. and all roads to the west.
- Contractor to start restoration work this spring on areas that have been tested and passed inspection.
- Asphalt work will begin once roadway preparation is complete and asphalt companies are open.
